Don’t Lose Your LMW Status: The Essential RMCD LMW License Renewal Checklist

LMW License Renewal: The RMCD Checklist That Pops Your Tax-Free Status

For export-oriented manufacturers in Malaysia, an active Licensed Manufacturing Warehouse (LMW) status acts as an invisible, tax-free shield wrapped tightly around your factory floor.

If you allow that shield to drop because of a botched license renewal, the financial consequences are catastrophic. The Royal Malaysian Customs Department (RMCD) doesn't just reject your application and ask you to try again. They immediately revoke your bonded status, freezing your supply chain at the ports and slapping your company with instant import duties and sales tax on every gram of raw material sitting in your facility.

To keep your production lines moving and avoid a devastating statutory compliance audit, you must navigate the hidden traps of the renewal process, starting with the exact timeline you must follow to protect your facility. Maintaining a Licensed Manufacturing Warehouse (LMW) status is one of the most powerful tax privileges available to export-oriented manufacturers in Malaysia. However, when it comes time for LMW license renewal, many factory managers find themselves asking: Anyone else stuck in LMW license renewal hell?

The 120-Day Ticking Clock

Customs mandates that your Lampiran B renewal dossier must be lodged at least 90 days before your license expires. If you wait until Day 90 to start gathering your paperwork, you have already lost.

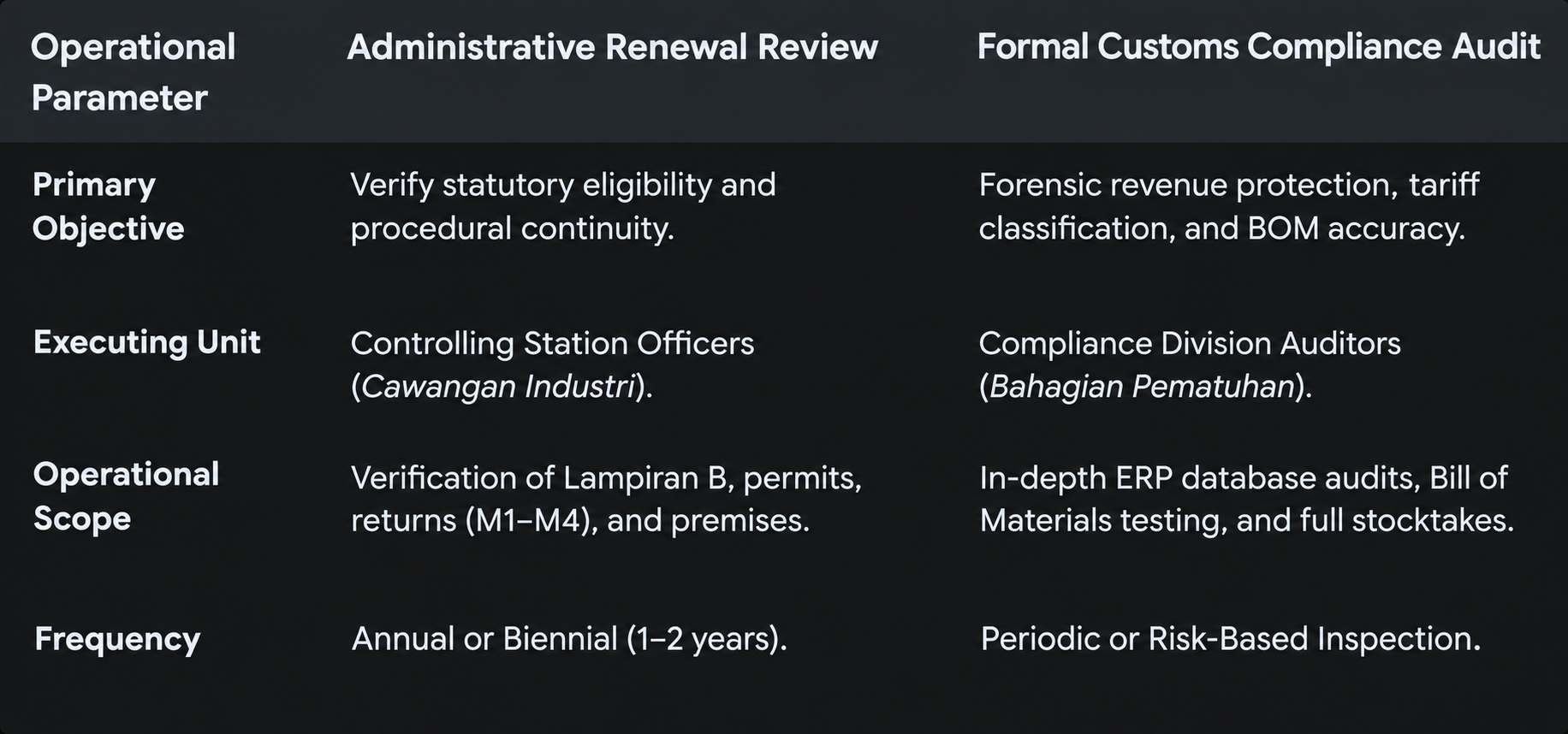

The most effective trade compliance teams operate on a 120-day timeline. You must spend Days 120 to 91 conducting a ruthless internal audit. By the time Day 90 arrives, your Lampiran B forms—submitted in physical triplicate to your controlling Customs station—must be flawless. The remaining 90 days are entirely consumed by RMCD's administrative evaluation, responding to formal query letters, and hosting Customs officers for on-site premise inspections.

The 4 Hidden Renewal Traps

Trap 1: The Mass-Balance Scale (Lampiran Returns)

Customs accounting is a strict, two-sided balance scale. Every single gram of duty-free raw material imported on the left side of the scale must equal the finished goods exported on the right side, plus any documented manufacturing scrap.

Before you apply for renewal, RMCD will check if your monthly stock returns—Lampiran M1 (raw materials), M2 (finished products), and H (subcontracting)—perfectly balance. Customs will evaluate your past 12 to 24 months of submission accuracy, including whether your monthly LMW reports and subcontracting approvals were filed without gaps. If they don't, Customs assumes you illegally sold the missing materials locally. Under Section 65AB of the Customs Act 1967, this triggers an immediate, non-negotiable tax demand.

Trap 2: The 80% Bucket Rule

When Customs officers walk your factory floor during a pre-renewal inspection, they are verifying your primary export mandate. Your LMW is a bucket; at least 80% of the production value that pours out of it must go overseas.

If your local sales exceed the 20% cap without explicit authorization, or if those domestic sales are missing the required Customs Form No. 9 tax declarations and duty payments, your renewal will be frozen.

Trap 3: The Unapproved Renovation

Officers do not just check paperwork; they check your physical walls. The LMW tax shield is bound to a highly specific, approved floor plan.

If your operations team knocked down an internal partition wall, extended a storage shed, or added a side door without prior written approval from the State Customs Director, you have violated Regulation 47 of the Customs Regulations 1977. RMCD treats unapproved structural changes as a breach of your bonded security perimeter, halting your renewal immediately until the layout is regularized. In short, any major structural alterations made since your original LMW license application must be declared and re-certified.

Trap 4: Mixing Renewals with Scope Amendments

Form Lampiran B is strictly designed to extend your existing operations. It is not an expansion permit.

Trying to add new finished product lines, new raw material HS tariff codes, or new production machinery inside a basic renewal form guarantees immediate rejection. You must file separate, formal scope amendment applications distinct from your standard renewal filings to ensure a smooth, single-pass approval.

Secure Your Renewal Before Expiry

In regulatory compliance, hope is not a strategy. You cannot submit your Lampiran B application and blindly pray for approval, knowing a rejected renewal stops your production lines and forces you to bleed cash on import duties.

Strategic preparation eliminates audit anxiety. Baryk Partners is a boutique Customs, LMW, and SST advisory firm led by a former senior Royal Malaysian Customs Department (RMCD) officer with over a decade of direct frontline regulatory and audit experience. We specialize in pre-renewal compliance audits, Lampiran reconciliation, and direct RMCD officer management. By auditing your inventory mass-balance and defending your machinery lists before Customs arrives, we ensure your bonded status remains unbroken.

If your renewal deadline is approaching or you need assistance clearing customs queries, consult our LMW advisory and renewal team. Book a confidential LMW Health Check with our compliance team today to secure your renewal well before your expiry date hits:
